Projects by
Hulett & Associates

Risk Analysis of the Department of Homeland Security Headquarters Building, Washington DC

  • Client: US General Services Administration, Public Buildings Service, Washington, DC

  • Contact: Jason Lopez

  • Date of Services: 2015 - 2016

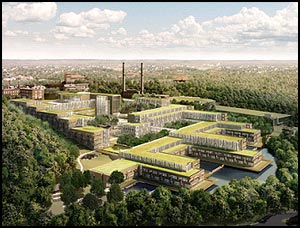

Proposed Coast Guard headquarters

The Department of Homeland Security Headquarters building is being constructed on the grounds of St. Elizabeth’s Hospital in Anacostia, DC. Hulett & Associates performed an integrated schedule and cost risk analysis of the project for the General Services Administration. The entire project is the largest, most complex construction project in GSA’s history. Hulett used the Risk Drivers Method applied to cost risk analysis. The Risk Drivers Method allowed the GSA to see how much schedule and cost risk there was in this project as well as which risks were most important in driving that cost risk.

Historic building to be incorporated into Coast Guard headquarters

The picture above shows the proposed Coast Guard Headquarters building.

The picture on the right shows the historic Center building that is being retrofitted for adaptive reuse.

The completion date for St. E’s has been a moving target, but DHS officials have told Congress that it expects to wrap up the project by 2026. A revised third master plan for the campus was due by the end of December 2018, but Bart Bush, DHS’s senior executive for real estate, facilities, planning and asset management, said GSA is in the “final stages” of a master plan amendment to build out more than 1.3 million square feet on the campus. The original plan for St. Elizabeths calls for 4.5 million square feet of built space on the campus.

Ribbon-cutting

While Congress has appropriated more than $2 billion overall for the DHS campus, the fiscal 2019 appropriations bill fell short of the agency’s request for funds to build a headquarters for the Federal Emergency Management Agency. These and previous funding shortfalls have created a domino effect for other DHS components: Immigration and Customs Enforcement should have received full funding for its headquarters in fiscal 2018, and Customs and Border Protection should’ve gotten its funding in fiscal 2019, but both of those projects have yet to move forward. (The picture at the right shows the completed Coast Guard Headquarters building. The picture on the left shows the ceremonial ribbon-cutting for the historic Center building that has been retrofitted for adaptive reuse.)

Schedule Risk Analysis of a Chemical Plant Construction Project

  • Client: BASF S.E.

  • Contact: Alexander Strazmesterov

  • Date of Services: 2013

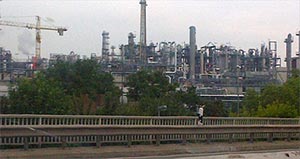

Schedule Risk Analysis at BASF, Germany

Hulett & Associates, LLC partnered with lead firm, PMA Consultants LLC, to conduct a schedule risk analysis of a chemical plant construction project being designed and built on the BASF Ludwigshafen site. There are several EPC contractors for different units. David Hulett was with Tarek Bahgat of PMA Consultants on-site in Germany for a total of 5 weeks in the summer of 2013.

The schedule risk analysis work involves: (1) PMA Consultants created an integrated analysis schedule smaller than the detailed schedules of the modules, (2) interviewing the project participants from BASF and their main contractor about schedule risks, (3) inserting the risks into the schedule using Primavera Risk Analysis Risk Register capability, (4) conducting Monte Carlo simulations of the schedule to determine both when the project is likely to finish under the current program, and (5) identity and prioritize the major project risks for each sub-project, (6) conduct a risk mitigation workshop with the project team focusing on the high-priority risks.

We used the risk data interviews to build a Risk Register.  These risks were developed and quantified in the Risk Register capability of Primavera Risk Analysis (a.k.a. Pertmaster, the Monte Carlo simulation package, a product of Primavera, a subsidiary of Oracle). Using the risk register approach we explicitly linked to the appropriate activities in the schedule for simulation.  Focusing on the risks makes it clear which risks affect the schedule. Also we prioritized the risks (not activities or schedule paths as historically was the case) to each of the EPC contracts.  (Picture of the BASF facility taken from the highway.)

Schedule Risk Analysis of the Cabin Gas Plant 1, British Columbia, Canada

  • Client: ENCANA, Calgary, Alberta, Canada

  • Contact: Randy Barker, Project Manager

  • Date of Services: 2012

Encana cabin gas plant

Hulett & Associates, LLC was asked by ENCANA of Calgary, Alberta to conduct schedule risk analyses on the Cabin Gas Plant 1 construction project. This project, the first of two plants planned on the site in upper-British Columbia, is in execution and planned to complete in mid-2012.

The schedule risk analysis work involves:

  1. Examining the project schedule for adequacy of logical relationships and improving the schedule so it meets best scheduling practice standards
  2. Interviewing the project participants from ENCANA, the owner, about schedule risks
  3. Conducting Monte Carlo simulations of the schedule to determine both when the project is likely to finish under the current program
  4. Identify and prioritize the major project risks
  5. Conduct a risk mitigation workshop with the project team focusing on the high-priority risks
  6. Analyze the improvement of the project’s performance that can be expected if the mitigation actions are taken. The improvement (earlier date for Mechanical Completion) is balanced against the cost of the mitigation actions to determine the benefit – cost of the actions.
Encana cabin gas plant

We used the Risk Driver approach to risk analysis capability of Pertmaster, the Monte Carlo simulation package (a product of Primavera, a subsidiary of Oracle), called Risk Factors. Using the risk driver approach we explicitly link with the prioritized list of risks found by qualitative methods and included in the Risk Register. We interviewed over a dozen owner personnel for (a) the probability that the risk will occur to cause a measurable impact on some schedule durations, the range of possible impacts if the risk occurs and the activities that would be affected.

During these interviews the interviewees added about 15 risks. Focusing on the risk shows how the risks affect the schedule. Correlations between activity durations are modeled, not guessed-at as before. Also we can prioritize risks, not activities or schedule paths as historically was the case. From this basis we can prioritize the risks that drive overall project cost and schedule risk, hence provide assistance for the program to conducted prioritized risk mitigation. (Pictures from ENCANA, September 2011)

NASA Stratospheric Observatory for Infrared Astronomy (SOFIA)

  • Client: NASA Independent Program Assessment Office (IPAO), Langley Research Center, VA

  • Contact: Howard Lewis

  • Date of Services: 2010

Boeing 747

The SOFIA project uses a modified Boeing 747 to carry instruments aloft for astronomical observations. The purpose is to fly above 99% of the Earth’s atmospheric water vapor, thereby allowing infrared images that cover the full spectrum. This joint NASA / German (DLR) project will offer international science teams approximately 1,000 cloud-free high-altitude (over 45,000 feet) science observing hours per year. It includes a German 2.7 meter telescope mounted in a modified Boeing 747-SP.

The project includes a German 2.7 meter telescope

IPAO’s Standing Review Board (SRB has looked at this project periodically. In 2010 the SRB reviewed the SOFIA program’s schedule and joint cost-schedule confidence limit risk analysis and conducted its own JCL, which was adopted by the program. Hulett & Associates, LLC supported the SRB and conducted the schedule assessment and JCL analysis.

Risk Analysis of Gas Projects for Petronas, Kuala Lumpur, Malaysia

  • Client: Carigali Unit of Petroliam Nasional Berhad (Petronas), the National Oil Company of Malaysia

  • Contact: A Khalid B Jaafar

  • Date of Services: 2009

An offshore project

Hulett & Associates, LLC

Hulett & Associates, LLC has been working with Petronas since 2005 and has conducted seven (7) integrated cost and schedule risk analyses, mostly on offshore gas production platform projects including procurement, fabrication, installing of the jacket and topsides, drilling gas wells and laying pipelines between the platform and the shore.  Several of these projects are in Malaysian waters but some are elsewhere (e.g., Turkmenistan in the Caspian Sea).  Other projects include a chemical plant, a natural gas pipeline project in Borneo (East Malaysia) and a water pipeline.

The analysis involved:
  1. Examining the schedule for its agreement with best practice scheduling.
  2. Reviewing the prioritized risk list and setting up the interviews of project participants.
pipeline
  1. Interviewing many, usually more than 30, participants sometimes in different locations (e.g. traveled to Turkmenistan, Myanmar, and India), including management and even contractors if available, on the risks.
  2. Running the Monte Carlo simulations to estimate the overall project schedule and cost risk.
  3. Prioritizing the individual risks to schedule and to cost.
  4. Holding a risk mitigation workshop with the project manager and team to develop mitigation actions.
  5. These results were reported to three increasingly-high levels of Petronas Carigali management.
Improving the Schedule and Cost for Risk Analysis.jpg

The picture of topsides on the jacket is representative of the offshore projects. The pipeline picture represents that which will be built in East Malaysia.


Risk Analysis of VA Hospital Construction Project Las Vegas, NV

  • Client: US Government Accountability Office (GAO)

  • Contact: Karen Richey

  • Date of Services: 2009

GAO team on site visit

Hulett & Associates, LLC has been working with GAO in assessing project schedules for federal acquisition programs since 2008. In 2009 GAO decided to conduct a schedule risk analysis on the VA Hospital project that is being constructed north of Las Vegas, NV.

The analysis involved:

  1. Examining the schedule for its agreement with best practice scheduling.
  2. Reviewing the prioritized risk list and setting up the interviews of project participants.
GAO team on site
  1. Interviewing the chief engineers and project managers, and the construction contractor and their consulting scheduler on the risks (their probability of occurring, their impact if they do occur and the activities that they affect) using the Risk Driver method of risk analysis.
  2. Running the Monte Carlo simulations to estimate the overall project schedule and cost risk.
  3. Prioritizing the individual risks to schedule.
  4. Producing a risk analysis result for GAO.
  5. These results were reported to the US Congressional committee that requested GAO to examine this project.

The pictures represent the GAO team, along with a representative of the project manager, on the site visit.

Risk Analysis of the YANBU Export Refinery Project, Houston, TX

  • Client: ConocoPhillips, Houston, TX

  • Contact: Mike Elliott, Phillips 66 Company

  • Date of Services: 2006 - 2008

Hulett & Associates, LLC was contracted by ConocoPhillips since 2004 to conduct schedule and cost risk analyses on some of their major projects including refinery construction in the US and offshore drilling and onshore gas processing plant projects in Qatar among others. The most significant project is the 2006 planning and construction of the YANBU Export Refinery Project, a large 400,000 barrel-per-day multibillion dollar greenfield refinery in Saudi Arabia in partnership with Saudi Aramco. All of the work has been performed in the US, mostly in Houston, TX.

The schedule risk analysis work involved:

  1. Examining the project schedule for adequacy of logical relationships and improving the schedule so it meets best scheduling practice standards.
  2. Interviewing the project participants from ConocoPhillips and Saudi Aramco as well as the engineering contractor (KBR) personnel about schedule and cost risks.
  3. Conducting Monte Carlo simulations of the schedule and costs to determine both when the project is likely to finish and how much it is likely to cost under the current program.
  4. Identitying the major project risks.
Planned site for YERP

Two analytical advances were made on this assignment.

First, we conducted fully integrated cost and schedule risk analysis by putting resources into the schedule and simulating them cost and time together. In this way, schedule risks are allowed to affect labor-type resources’ costs.

Second, we used the Risk Driver approach to risk analysis by getting Pertmaster, the Monte Carlo simulation package (now owned by Primavera, a subsidiary of Oracle) to develop the Risk Factors Module. Using the risk driver approach we explicitly link with the prioritized list of risks found by qualitative methods and included in the Risk Register, so we can prioritize risks, not activities or schedule paths as historically was the case.

From this basis we can prioritize the risks that drive overall project cost and schedule risk, hence provide assistance for the program to conducted prioritized risk mitigation. (Picture a typical refinery, the YANBU project as completed is shown on the site pictured on the right above.)

Risk Analysis of the Capitol Visitor Center project, Washington, DC

  • Client: US Government Accountability Office (GAO)

  • Contact: Terrell Dorn

  • Date of Services: 2006

Area where CVC is built

The Capitol Visitor Center (CVC) project was completed in 2008 over budget and schedule. In 2003 the US Congress asked the Government Accountability Office (then the Government Accounting Office) to review the cost and schedule performance and risk in order to report to Congress in monthly hearings. Hulett & Associates, LLC was contracted to the GAO through their support contractor, UNICCO, to make the assessment using modern project schedule and cost risk analysis methods and tools.

CVC interior

We conducted quantitative risk analysis of schedule and cost, including integrated cost/schedule risk analysis, 3 times between 2003 and 2006. We examined the project schedule (4,500 activities) against best-practice scheduling standards and worked with the project scheduler to make substantial improvements. We conducted extensive interviews to develop the risk data that was used in the Monte Carlo simulations of the project cost and schedule.

Our reports to the GAO were used several times by the GAO in their briefings to Congress. The GAO became recognized as knowing more about the CVC project’s cost and schedule than the Architect of the Capitol who was the owner. Hulett has used associates to do some of the work, though David Hulett has supervised the entire effort.

The picture above indicates the area where the CVC is built, underground, between the Capitol and First Street. The finished interior is also pictured.

Integrated Cost and Schedule Risk Analysis for the D&D of Two Reactors (BGRR and HFBR) at Brookhaven National Lab

  • Client: Brookhaven National Laboratory

  • Contact: Michael Cowell

  • Date of Services: 2006

Hulett & Associates, LLC assisted Brookhaven National Laboratory with an integrated cost and schedule risk analysis for the decommissioning of two research reactors:

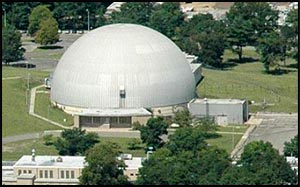

HFBR Dome
  • The Brookhaven Graphite Research Reactor (BGRR), a small research reactor that was permanently shut down after being operated on the Lab site from 1950 through 1968.  BNL has made significant progress in cleanup of the HFBR, removing contaminated ancillary structures, underground pipes and ducts, control rod blades, and beam plugs, and putting the facility in a stable state for its hibernation.
  • The High Flux Beam Reactor (HFBR), a small research reactor that was permanently shut down by DOE in 1999 after being operated on the Lab site from 1965 through 1996.The removal of BGRR graphite pile commenced in early 2010 and was completed in May of 2010; the removal of the biological shield will follow.
BGRR at night

The integrated cost and schedule risk analysis used a Primavera P3 schedule developed on site that had detailed resources defined, costed and assigned to the activities. We worked with Pertmaster (now Oracle / Primavera) to configure Pertmaster Risk Expert (now Primavera Risk Analysis) software to accept the identification of time-dependent and time-independent resources so that the risk analysis could capture the impact of schedule uncertainty on the cost uncertainty.

The HFBR Dome is in the photograph at the right. On the left is the BGRR photographed at night.

SFOBB East Span Seismic Safety Project, Oakland, CA

  • Client: California Department of Transportation (Caltrans), Oakland CA

  • Contact: Jon Tapping

  • Date of Services: 2005

San Francisco-Oakland Bay Bridge Seismic Replacement Project

The project is the San Francisco-Oakland Bay Bridge Seismic Replacement Project being executed by Caltrans District 4. The contract was with Caltrop Corporation. Caltrop was asked to assist Caltrans with the risk analysis of this project. Caltrans hired Hulett & Associates, LLC to assist in this effort.

We began by organizing and conducting a risk identification workshop that identified nearly 100 project risks. Then we organized and conducted a qualitative risk analysis workshop that prioritized the main risks by assessing their probability of occurring and the impact on schedule, cost and scope if they were to occur. The result was a list of risks that were grouped into high, moderate and low risks to the project.

San Francisco-Oakland Bay Bridge Seismic Replacement Project

We then examined a small schedule of the project that had been put together by Bechtel. That schedule was improved based on our assessment of it against best scheduling practices. We conducted a workshop to quantify the uncertainty in duration for the main activities. We performed a Monte Carlo simulation to determine when the project might finish based on the then-current schedule and the risk data. We prioritized the risks to the schedule. Then we worked with the cost estimate model and interviewed for project risk of the line-item cost elements. We brought into the cost risk estimate the information from the schedule risk for an integrated cost-schedule risk analysis. This information has formed the basis for the subsequent Caltrans risk assessment quarterly reports to the State.

Risk Analysis of Offshore Oil Production Platform, Refinery Upgrades, and FPSOs

  • Client: Petróleo Brasileiro S.A (Petrobras) the National Oil Company of Brazil

  • Contact: Carlos Eduardo Braga

  • Date of Services: 2002

Offshore platform

Hulett & Associates, LLC has been working with Petrobras to provide quantitative project risk analysis of cost and schedule for offshore oil production platforms and FPSOs, pipelines, drilling, and refinery improvements. We have also provided training in these subjects to Petrobras personnel.

The analysis involves:

  1. Examining the schedule for its agreement with best practice scheduling
  2. Reviewing the prioritized risk list and setting up the interviews of project participants
  3. Interviewing the chief engineers and project managers, and the construction contractor and their consulting scheduler on the risks (their probability of occurring, their impact if they do occur, and the activities that they affect) using the Risk Driver method of risk analysis
  4. Running the Monte Carlo simulations to estimate
    Refinery expansion
    the overall project schedule and cost risk
  5. Prioritizing the individual risks to schedule
  6. Producing a risk analysis result for GAO
  7. These results were reported to the US Congressional committee that requested GAO to examine this project.

(The pictures represent the type of projects that have been reviewed, including an offshore platform, three FPSO projects and a refinery expansion project.)

US Army Stockpile Chemical Demilitarization Project

  • Client: US Department of Defense

  • Contact: Ted Prociv, Pentagon

  • Date of Services: 1998-2000

Nerve gas and mustard gas agents had been stored in bunkers at seven storage facilities for many years. At some of these there was evidence of leakage contained within the bunkers. The stockpile included some agents that were weaponized (e.g., inserted into rockets and land mines) and some were in bulk containers.

UMDCF M55 Rocket Disassembly

The technology for destroying nerve and mustard agent was being debated, with several of the largest sites (Deseret Chemical Depot in Utah, Anniston Alabama, Pine Bluff Arkansas and Umatilla Oregon) as well as Johnston Atoll off Hawaii employing incineration technology.  Other sites (Newport Indiana, Aberdeen Maryland, Pueblo Colorado and Blue Grass Kentucky) used a chemical neutralization methodology.

The US complied with the 1997 Chemical Weapons Convention, an international treaty which the United States and more than 150 other nations have signed as their pledge to rid the world of chemical weapons. The technology and the environmental issues, requiring superfund-type environmental permit requirements, led to uncertainty about the building of the plants. Operating risks affected the program’s ability to destroy the agents once the plants were completed.

chemical demilitarization

Hulett was engaged by SAIC, the project manager contract for the chemical demilitarization program to perform a cost risk analysis of the entire 7-site system of process plants designed to destroy the US stockpile of nerve gas and mustard gas. Soon after that assignment, Hulett was requested to also conduct a cost risk analysis. Recognizing that much cost risk will occur as the result of uncertainty in the schedule, we performed an early integrated cost – schedule risk analysis.

The Pentagon desired the analysis to be done by one of the (then) big six accounting firms, so we turned to Arthur Anderson of Houston Texas and they became the prime contractor for this effort. We were also commissioned to analyze the project risk analysis for the ACUA investigation of technologies alternative to incineration that would be used for the Blue Grass and Pueblo sites. The Chemical Stockpile Demilitarization program has destroyed 90% of the stockpile, with agent remaining at Pueblo, Colorado, and Blue Grass in Kentucky.

Anadarko LNG Project (now owned by Total)

  • Client: Anadarko Petroleum Co.

  • Contact: Waylon Whitehead (formeerly of Anadarko)

  • Date of Services: 2018

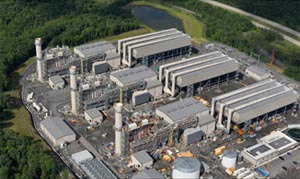

Anadarko site

Anadarko-led Mozambique LNG is a consortium of companies working to develop the first offshore gas field and onshore LNG facility in Mozambique. Approximately 75 Tcf of recoverable natural gas has been discovered in the Offshore Area 1. The natural gas found is approximately 40 kilometers offshore and in water depths of approximately 1,600 meters. Initial plans are for a two-train project. Well established technology is being engineered for this facility. The participation of a Mozambican workforce, procurement of local goods and services is integral to the successful development and operation of Mozambique LNG. Anadarko anticipates being in a position to take the final investment decision (FID) in the first half of 2019.

Hulett worked with Anadarko staff who were developing the summary schedule and putting costs (labor and material) on that schedule.  We collected risk data from nearly 75 project participants, some in interviews and others through email solicitations. Most of these were in Houston but some were from on-site in Mozambique.  Risks were modeled on the schedule using Polaris® from Booz Allen Hamilton.  Pre-mitigated results including some scenarios were delivered to the client.
(Internet picture represents a completed LNG project)

Schedule Risk Analysis of a Chemical (Fertilizer) Plant Construction Project

  • Client: thyssenkrupp Industrial Solutions

  • Contact: Malte Wittling

  • Date of Services: 2016

Hulett & Associates, LLC partnered with scheduling subcontractor MBP Engineering, to conduct a cost - schedule risk analysis of a chemical plant construction project being designed for a site in southern Ohio. David Hulett was on-site in Dortmund Germany for 7 weeks in the summer of 2016.

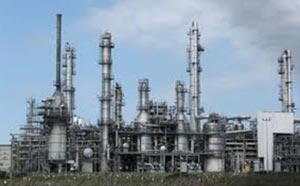

Thyssenkrupp site

The schedule risk analysis work involved: (1) MBP creating an integrated analysis schedule with resources applied, (2) interviewing the project participants from thyssenkrupp, (3) inserting the risks into the schedule simulation package Polaris from Booz Allen Hamilton, (4) conducting Monte Carlo simulations of the cost and schedule to determine both when the project is likely to finish under the current program, (5) identity and prioritize the major project risks, and (6) conduct a risk mitigation workshop with the project team focusing on the high-priority risks. We benefitted from the existing Risk Register.

The project’s engineering and construction plans have been stalled. The construction of a $2.8 billion fertilizer plant in southwestern Indiana is still on track following the resolution of a dispute with the Internal Revenue Service, the facility's developers said. Construction of the Midwest Fertilizer Co. project in Posey County has been planned since 2016 but faced delays. Midwest Fertilizer chose to base the 220-acre plant in Posey County because the Indiana Economic Development Corp. offered a tax-incentive package in late 2012. (stock chemical plant picture) )

Publications

  • “It is to be hoped that Hulett's approach will be adopted... to produce more realistic... projections of project outcomes - to set more achievable targets and to point towards more effective risk mitigation actions.”
    -- Philip Rawlings, Director, Euro Log Ltd

  • “This is an extremely important book, which presents a depth of understanding of estimating and scheduling rarely seen in industry.”
    -- John Greenwood

David T. Hulett, Ph.D. FAACE
